TTT Header Integrity Program

A new approach to HRSG header replacement

Header replacement can be one of the most labor-intensive and outage-critical repairs performed within an HRSG.

The TTT Header Integrity Program combines patented Tuff Tube Transition connection technology with engineering, fabrication and installation strategies designed to improve the integrity of the replacement assembly while dramatically simplifying field installation.

TTT-lined headers utilize the Tuff Tube Header Connection (TTHC) within the fabricated header assembly, with Tuff Tube Purgeless Sleeves (TTPS) available to simplify tube-to-tube field connections during full header replacement.

The result is a replacement strategy designed around quality, installation efficiency and long-term connection integrity.

The real failure location

When the header isn't the real problem

After repeated tube failures, a plant may eventually decide to remove and replace an entire header section with a conventional prefabricated stubbed header.

But in recurring tube-to-header failure scenarios, the header itself may not be the component driving the replacement. The vulnerable area can instead be associated with the tube-to-header connection and the Heat Affected Zone created where relatively thin-walled tube material is welded to the substantially heavier header.

The Header Integrity Program approaches the replacement differently: rather than simply reproducing the conventional connection configuration, TTT technology is incorporated into the replacement strategy to address the connection itself.

Reengineering the connection

Move the weld away from the thin tube wall.

One of the most challenging areas of a conventional header assembly is the transition between the relatively thin tube wall and the substantially heavier header.

Conventional configurations can place significant welding and thermal effects directly onto the thin tube material.

The Tuff Tube Header Connection changes that geometry.

The TTHC is designed to reduce the thermal fatigue difference at the tube-to-header connection and move the welding interface away from the vulnerable conventional configuration.

When incorporated into a new replacement header, TTHCs can be fabricated into the assembly under controlled shop conditions before the completed header is delivered to the plant.

3D render of a full header section with integrated TTHC tube-to-header connections

From engineering to installation

One engineered sequence.

01

Engineering & project review

The existing header configuration, materials, dimensions and operating requirements are reviewed to determine the appropriate TTT-lined replacement configuration.

02

Engineered TTHC connections

TTHCs are designed and manufactured for the specific tube-to-header application.

03

Header fabrication

The TTHCs are integrated into the replacement header assembly during fabrication, allowing critical work to be completed before the outage installation begins.

04

Engineering validation

Where appropriate, Finite Element Analysis can be used to compare the proposed TTT-lined configuration against the conventional design and evaluate stresses at the connection.

05

Field installation

The completed assembly is installed during the outage. TTPS connections can also be incorporated where appropriate for tube-to-tube field tie-ins, reducing the complexity associated with conventional open-root butt welds.

Program in action

See the Header Integrity Program in Action

Follow the Wise County replacement headers through controlled shop fabrication before field installation.

Real-world case study — Wise County, Texas, USA

Replacement of three RH1 lower reheat headers

Material
Grade 22 / 2¼ Chrome
Installation
Completed in 5 days
Scope
Engineering, fabrication and installation of three replacement reheat headers using TTT connection technology

For this project, conventional proposals estimated an installation duration of approximately 6–8 weeks. Viking Vessel Services engineered, constructed and installed the replacement headers using TTT technology.

“We received proposals from competitors with conventional installation methods that averaged installation times for 6–8 weeks. The Viking team was able to install these headers in 5 days.”

The result

5 DAYS

to install the new headers.

Field installation

Watch the Wise County Field Installation

Field installation and replacement of the Wise County reheat headers using TTT connection technology.

Wise County replacement header fabrication — welding TTHC connections in the shop

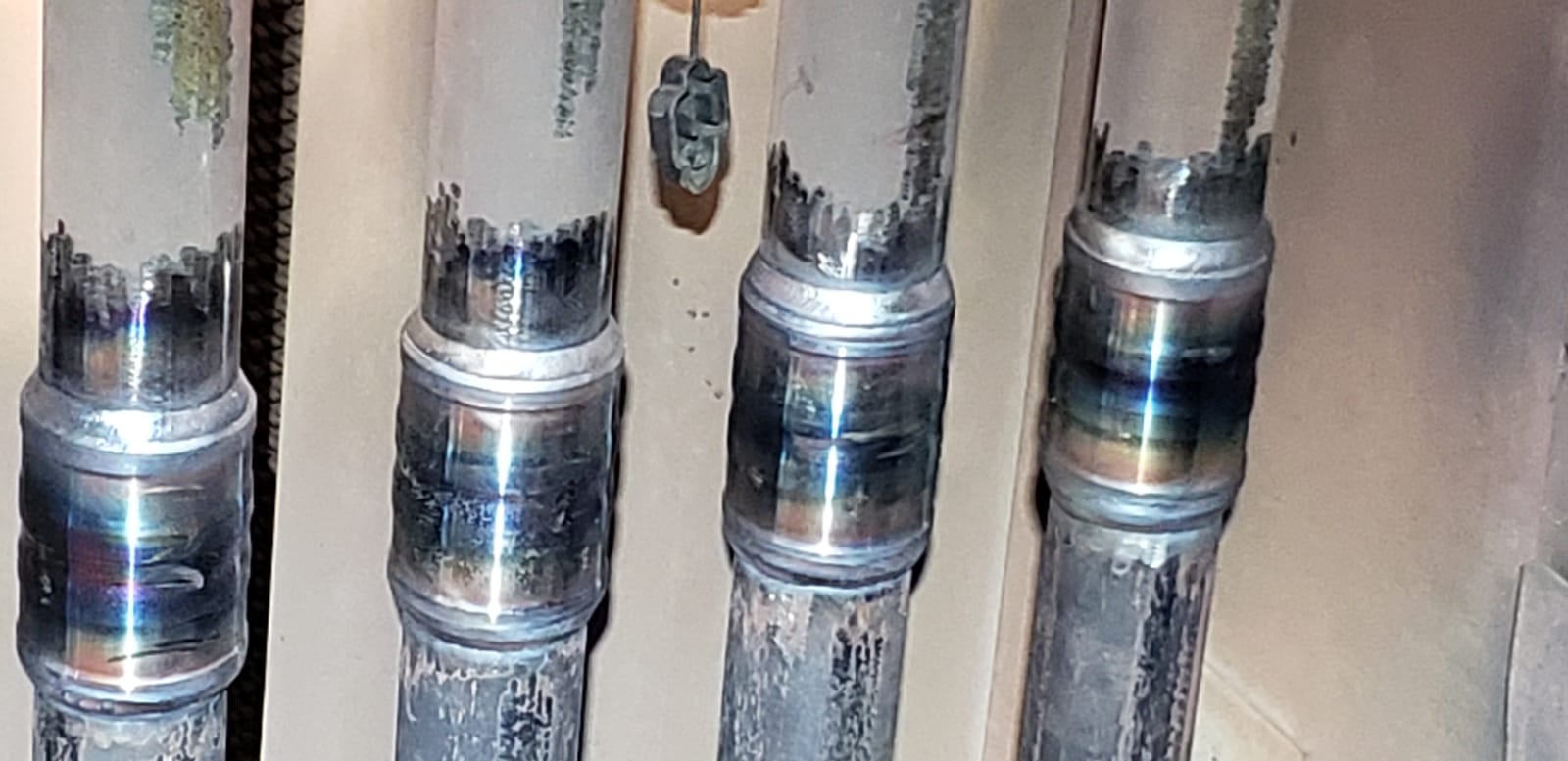

TTHC connections fabricated into the replacement reheat header assembly

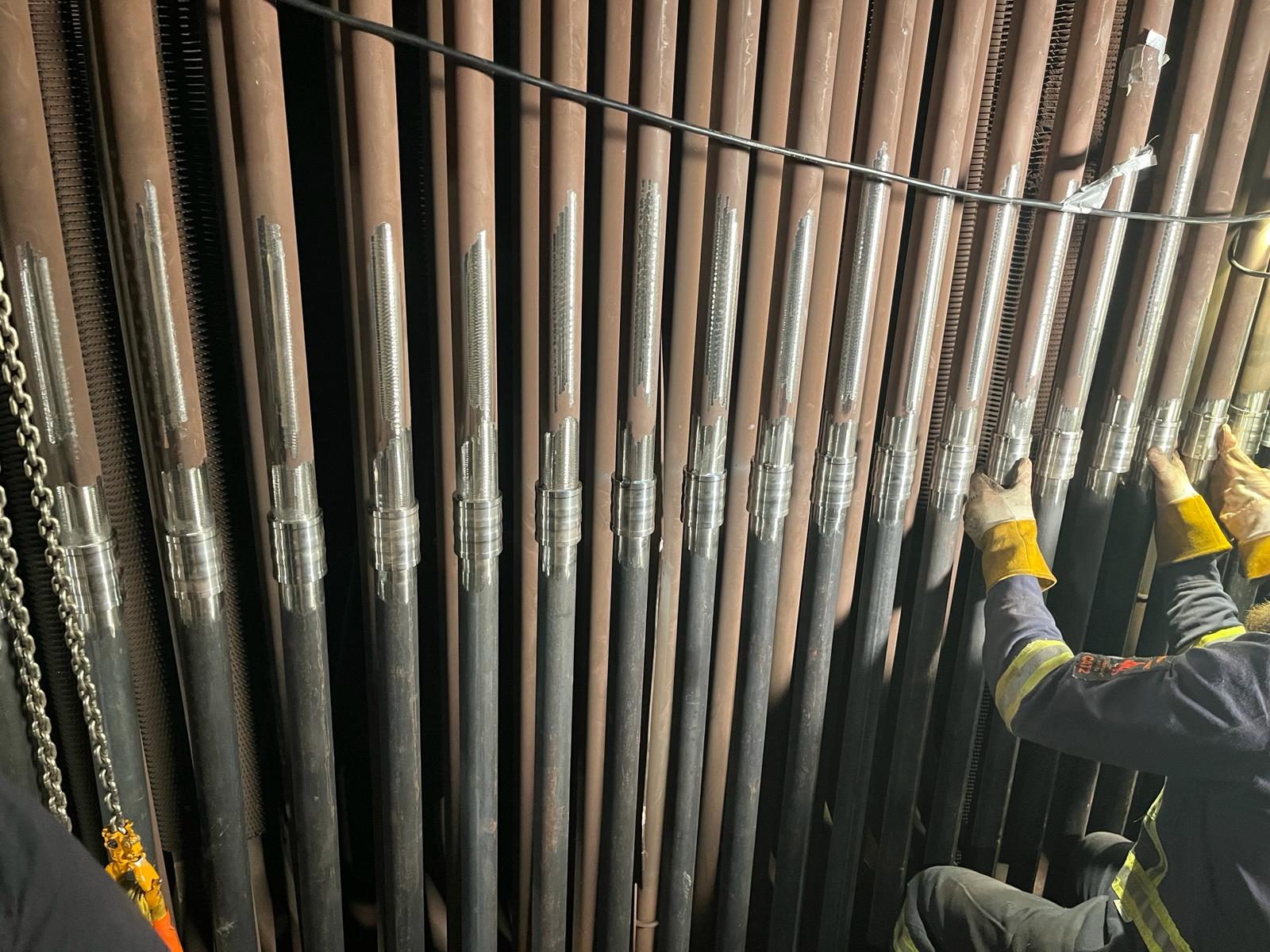

Row of tube connections on the Wise County replacement header during field work
Replacement reheat header installed at the Wise County plant

Engineered — not just faster

Speed was only part of the objective.

Finite Element Analysis was performed as part of the Wise County project to evaluate the TTT tube-to-header connection against the conventional/OEM configuration.

According to the plant’s written testimony, the analysis showed the Viking-designed tube-to-header connection to be:

53% STRONGER

than the OEM connection evaluated for the project.

Per the customer’s written testimony

This is important because the Header Integrity Program isn't simply about finding a faster way to replace a header. It is about using the outage as an opportunity to address the connection itself.

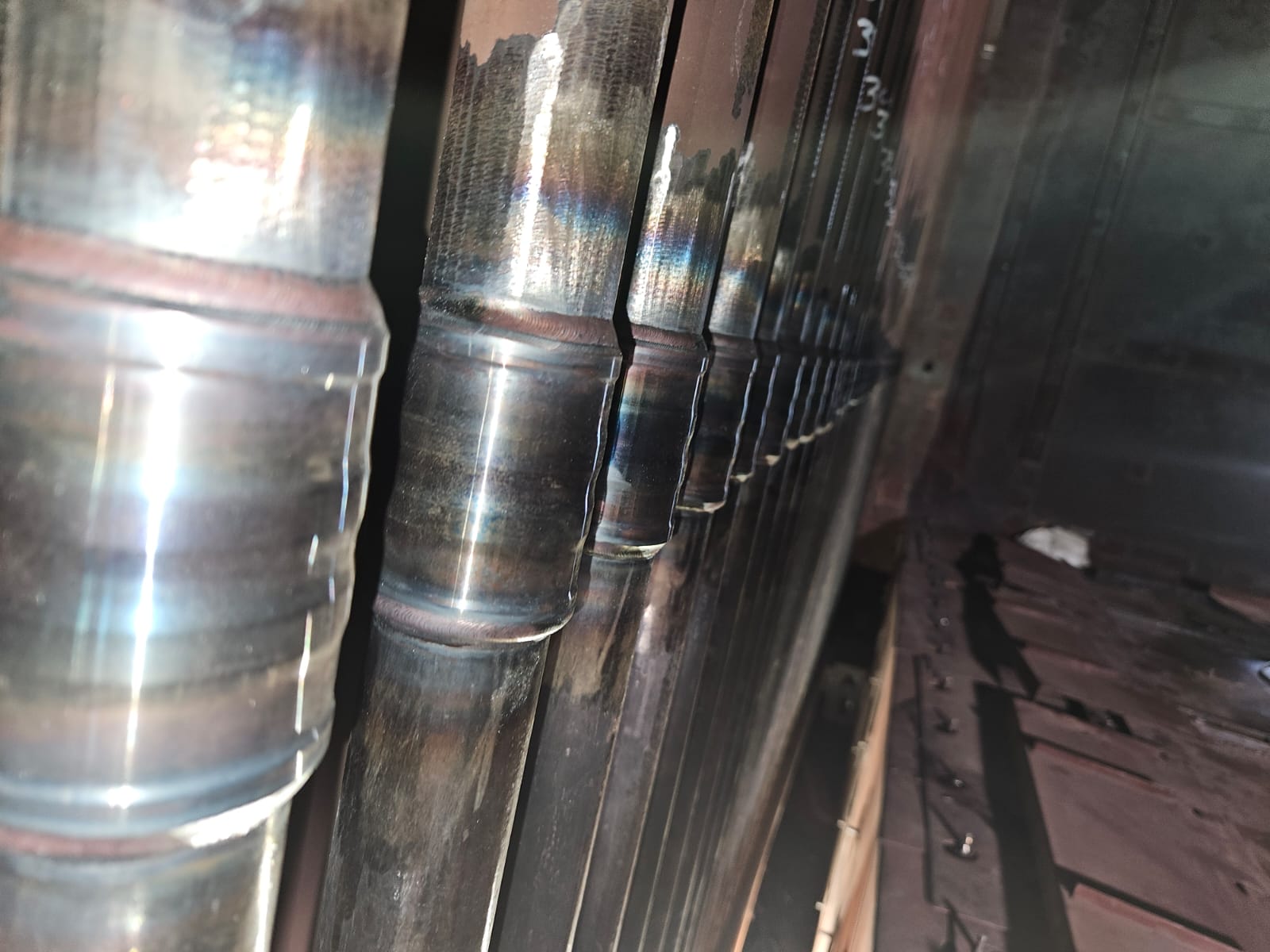

Completed TTT connections in the installed Wise County replacement header assembly

Performance after installation

Operating history, not just installation time.

The Wise County installation also gives us something particularly valuable: operating history.

150+

Starts

Accumulated at the time of the customer’s written testimony, plus a significant amount of baseload operation.

TWO

Inspections

Completed by the customer since installation at the time of the written testimony.

NO

Reported failure

No signs of premature failure or unanticipated wear or stress reported at the time of the written testimony.

“I look forward to using Viking for additional repairs, and replacements in the future.”

— Vistra Energy, Wise County Plant, Texas, USA

One program

One program. Multiple capabilities.

Where installation is required, Viking Vessel Services provides the field-service capability behind the TTT technology.

  • Engineering Review
  • TTT Connection Design
  • TTHC Integration
  • Replacement Header Fabrication
  • Finite Element Analysis
  • TTPS Field Tie-Ins
  • Quality Control
  • Field Installation Support

A complete connection strategy

TTHC + TTPS.

The Header Integrity Program brings together two core TTT technologies. TTHCs can be integrated into the fabricated header assembly for the tube-to-header connections, while TTPS components can be used where appropriate for tube-to-tube field tie-ins during installation.

TTHC Tuff Tube Header Connection 3D model

TTHC

Tube-to-Header

TTPS Tuff Tube Purgeless Sleeve 3D model

TTPS

Tube-to-Tube

Final call to action

When your header has to come out, replace more than the header.

Replace the conventional connection strategy with a system engineered around installation efficiency and connection integrity. Talk to us before your next planned header replacement.
